PAVEMENT ASSESSMENT · ASTM D6433

A rating per section, not a folder of photographs

The scan finds the distress. The assessment is what turns thousands of located defects into a condition rating per section and a repair list in the order the money should be spent.

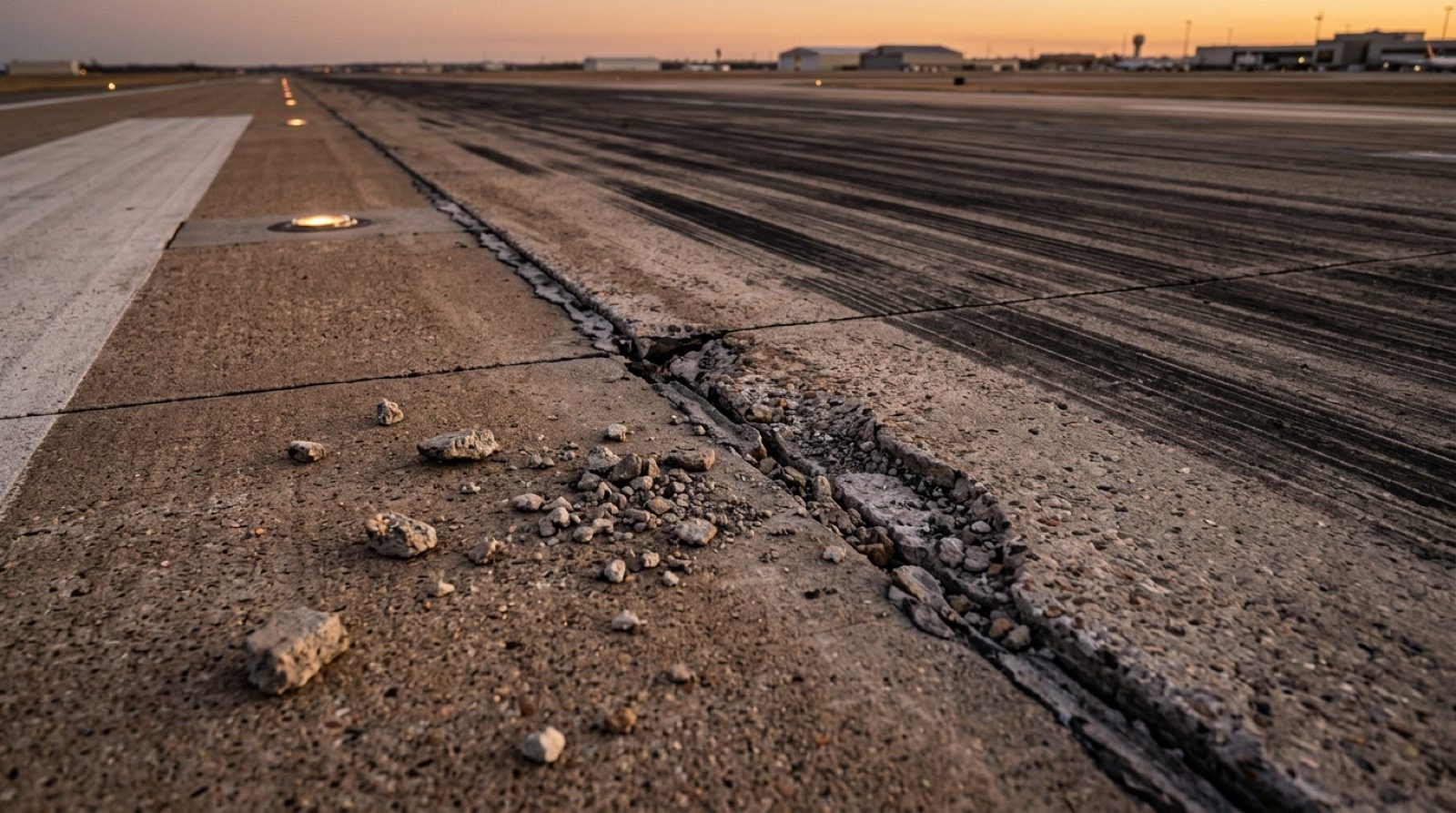

A failed transverse joint in a concrete runway with a spalled edge and loose fragments, at low sun
FAILED JOINT · SPALLED EDGE · LOW SUN
0–100
condition scale of the reported proxy
19 + 15
asphalt and concrete distress types in ASTM D6433
RTK ±1 cm
position carried by every recorded distress
per section
rating and repair priority are reported
FIT

Who this is for

For
Aerodrome operators who owe their authority a documented pavement condition record and currently rebuild it by walking the surface.
Airport engineering and maintenance managers deciding which sections to treat this budget year and which can wait.
Asset managers who already run a pavement management system and need a repeatable condition input for it.
Not for
Projects that require a formal ASTM D6433 or D5340 survey signed by a certified inspector, such as federally funded rehabilitation work.
Structural capacity questions, which need bearing strength testing rather than a surface condition rating.
Aerodromes wanting only raw imagery, which is delivered by the runway surface scan product instead.
JUDGED ON DELIVERY

Outcomes and acceptance criteria

01 A defensible condition figure per section

Every section you agreed to have assessed comes back with a Pavement Condition Index proxy on the 0 to 100 scale, the distress inventory the figure was computed from, and the section area it applies to.

Acceptance Open any section, and the deduct inputs behind its number are visible.
02 A repair list in priority order

Sections are ordered by condition and by the treatment band they fall into, so the list separates sections that still respond to preventive treatment from sections that have passed into rehabilitation.

Acceptance Every section on the list carries a reason, not just a rank.
03 A baseline the next visit can be compared against

Section boundaries, distress categories and positions are recorded so that the following assessment reports change rather than a fresh opinion.

Acceptance The section identifiers in this report are the identifiers used in the next one.
SCOPE AND DELIVERABLES

What is inside the assessment

Each deliverable with the party that owns it and the state it has to reach before the assessment is accepted.

11 parameters ASTM D6433 categories
01 Agreed section map

The network split into branches and sections, with boundaries fixed before capture and reused on every later assessment.

Owner TarmacView, signed off by the operator
02 Distress inventory

Every detected distress with its type, severity band, extent and surveyed position on the surface.

Owner TarmacView
03 Condition rating per section

A Pavement Condition Index proxy on the 0 to 100 scale with the distress densities that produced it.

Owner TarmacView
04 Ranked repair list

Sections ordered by condition and treatment band, each with the distresses that drive its position.

Owner TarmacView
05 Change report

On a repeat assessment, the rating movement per section and the distresses that grew, appeared or were repaired.

Owner TarmacView, from the previous baseline
06 Export for asset systems

The section table and distress inventory in the format the receiving pavement management system reads.

Owner Format nominated by the operator
07 Same-day hazard notice

Anything that reads as an immediate operational hazard, reported on the day of capture rather than with the assessment.

Owner TarmacView
08 Airside access and coordination

Tower coordination, escort where required, and the movement windows the capture is flown in.

Owner Aerodrome operator
09 Treatment design and costing

Not included. The assessment says what condition the pavement is in, not what to build.

Owner Excluded
10 Structural evaluation

Not included. Bearing strength needs load testing or coring rather than a surface survey.

Owner Excluded
11 Friction and texture measurement

Not included. Continuous friction measuring equipment is a separate instrument and a separate visit.

Owner Excluded
Distress categories follow ASTM D6433. The reported index is a visual proxy calibrated against ground-surveyed results and is not a formal ASTM D6433 or D5340 survey.
DELIVERY · 6 STEPS

From section map to ranked repair list

01 Scoping call

You name the surfaces to assess and whether this is a first baseline or a repeat. We agree the section split, the export format and who signs off. Output is a scope note. If the section split cannot be agreed, the assessment does not start, because a rating against boundaries nobody accepts is worthless.

02 Mission build

The capture is planned from the surface geometry and the camera optics, so ground resolution and overlap are computed rather than assumed. Output is a validated mission and a capture window request to your tower.

03 Capture

Flown between aircraft movements. About an hour on site per runway, with taxiways and aprons added in proportion to area. If weather closes the window, the mission is reflown unchanged rather than rebuilt.

04 Detection and classification

Imagery goes through the surface analysis pipeline, which segments distress and classifies it by type and severity band. Detections below the confidence floor are held for human review rather than dropped silently.

05 Rating and ranking

Distress density is computed inside each agreed section and converted to a condition proxy on the 0 to 100 scale. Sections are then ordered by condition and treatment band.

06 Delivery and walkthrough

The report, the inventory and the export land together, and we walk your engineer through the sections that moved. Anything disputed is re-examined against the retained imagery rather than re-flown.

Surface scan path covering the full width of a runway
CAPTURE · FULL WIDTH · EVERY IMAGE GEOREFERENCED
EVIDENCE AND CAPABILITY

The claim worth checking is the rating

HOW THE PRICE IS BUILT

Four things move the quote

EUR per aerodrome per assessment excl. VAT EU Checked 2026-09-04
Cost driver 01 Paved area Capture time and processing both scale with it.
Cost driver 02 Surfaces and section split A runway split into four sections and one split into twenty are different reports off the same flight.
Cost driver 03 Baseline or repeat A repeat reuses the section map and the previous inventory and costs less than the assessment that created them.
Cost driver 04 Travel Shows up as travel and not as a different assessment.
EACH WITH AN OWNER

Risks and dependencies

Owner · WEATHER Weather and surface state

Standing water, snow cover and heavy contamination hide the surface from a camera. The mission is reflown rather than rated through the obstruction. This is nobody's fault and it is the most common reason a date moves.

Owner · OPERATOR Access

The capture needs tower coordination and, at most aerodromes, an escort. If the movement windows do not appear, the visit does not happen. That dependency sits with the aerodrome operator and it is worth confirming before travel is booked.

Owner · BOTH, AT SCOPING Section agreement

A rating is a statement about a defined area. If the section boundaries change between assessments, the time series breaks and the change report cannot be produced. We freeze the boundaries at scoping for exactly this reason, and changing them later is a decision with a cost rather than an edit.

Frequently Asked Questions

Is the PCI you report a formal ASTM D6433 value?
No. It is a visual proxy derived from automated image analysis and calibrated against ground-surveyed D6433 results, so it correlates with a formal PCI but is not one. A formal D6433 or D5340 survey requires a trained inspector to walk each sample unit, measure distress quantities by hand and compute the corrected deduct values. Where a funding programme or a legal reporting duty names the standard, the formal survey is still the instrument that satisfies it. The proxy is what lets you assess the whole network every year instead of a sample every five.
How is the pavement divided into sections?
By construction and use, the same way ASTM D6433 divides a network into branches, sections and sample units. A runway is normally split at construction joints, at surface type changes and at the touchdown zones, because those areas take different loading and deteriorate at different rates. Taxiways and aprons are split by geometry and by the traffic they carry. The split is agreed with you before the flight and then frozen, because a rating is only comparable between visits if the section boundaries stay in the same place.
How long does the aerodrome have to give us?
Capture is flown between aircraft movements in coordination with the tower, so no closure is booked for it. Budget about an hour on site per runway. Taxiways and aprons add time in proportion to their area rather than doubling the visit. The processing and rating happen afterwards, off site, so the time you give up is the capture window and nothing else.
What distress types do you classify?
The asphalt and concrete distress families that ASTM D6433 defines and that are visible from above: cracking of all orientations, block and fatigue cracking, potholes, patching, raveling and weathering, polished aggregate, joint spalling and sealant loss, corner breaks, scaling and faulting. Distresses that are not surface-visible are outside what any imaging method can rate. Rutting and depressions are reported where the surface model shows them, and are flagged as geometry rather than as a surface defect.
Can this feed our pavement management system?
Yes. The output is a table of sections with a rating, a distress inventory and a georeferenced position for every finding, which is the shape a pavement management system expects as a condition input. The section identifiers stay stable between assessments so a time series builds up rather than eight unrelated snapshots. Export formats are agreed at the scoping call, because the receiving system decides the format rather than we do.
What happens if the assessment finds something urgent?
Anything that reads as an immediate operational hazard, such as loose material on a movement area or an open spall in the touchdown zone, is reported on the day of capture rather than held for the assessment report. That is a safety notification and not a rating. The full assessment follows the normal schedule. This is the one part of the deliverable that does not wait for processing.

References

icao-doc-9137-p9
Doc 9137, Airport Services Manual, Part 9: Airport Maintenance Practices International Civil Aviation Organization
icao-annex-14-v1
Annex 14 to the Convention on International Civil Aviation, Volume I: Aerodrome Design and Operations International Civil Aviation Organization
Reviewed by Štefan Moravík · 2026-09-04
